How is target progress calculated?

Overview

Target progress indicates how far a learner is expected to be at a given point in time for:

  • A unit
  • A learning aim
  • Their overall portfolio

This helps track whether learners are on schedule to meet deadlines.


Centre Setting Impact

If your Centre has enabled “Apply weightings to target progress”, calculations will include weightings.
For more details, see the article on Progress Weightings.


Unit Target Progress

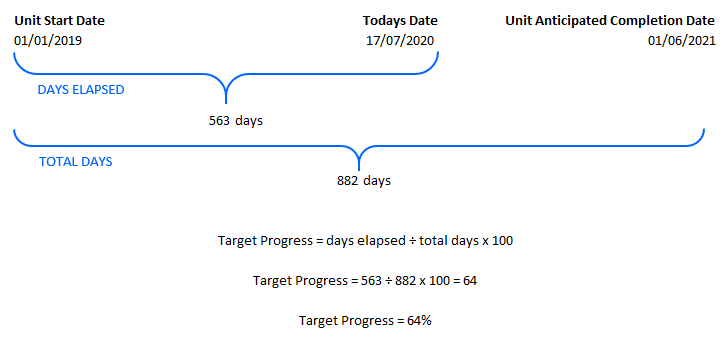

  • Calculated using:
    • Unit Start Date
    • Unit Anticipated Completion Date


Learning Aim Target Progress

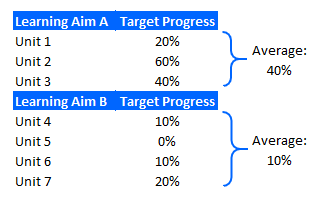

  • Calculated by taking an average of the target progress for all selected units within the learning aim.


Overall Target Progress

  • Calculated by taking an average of the target progress for all selected units across the portfolio.




Troubleshooting

IssueSolution
Target progress looks incorrectCheck start and anticipated completion dates for units and learning aims.
Weightings not appliedConfirm Centre setting for “Apply weightings to target progress” is enabled.

Terminology

Please note that the terminology used in this article may be different depending on your Centre.

Need Help?

If you encounter any issues or have questions, please contact Onefile Support or your internal support channels.
